CSI Division 31 25 00 • Environmental BMPs

Erosion Control & SWPPP Takeoff Services

Protect your bid margins and satisfy regulatory compliance. We provide complete quantity takeoffs for civil SWPPP sheets, including silt fence, stabilized construction entrance stone, inlet filter sacks, sediment traps, and slope stabilization matting.

SWPPP BMP Calculator →

SWPPP BMP Takeoff Deliverables

  • Perimeter Silt Fence: Standard & wire-backed LF + stake counts
  • Construction Entrances: Crushed stone ballast tons & geotextile SY
  • Inlet Protection: Drop inlet filter bags & curb sediment barriers (EA)
  • Sediment Basins & Traps: Excavation volume, rock baffles & skimmers
  • Erosion Control Blankets: Curlex/straw mats (SY) + staple counts
  • Temporary Seeding: Disturbed earth acreage & mulch requirements

Direct Technical Summary: What Is an Erosion Control and SWPPP Takeoff?

An erosion and sediment control takeoff is the engineering quantification of all temporary and permanent Best Management Practices (BMPs) mandated by the EPA National Pollutant Discharge Elimination System (NPDES) Construction General Permit and governed under CSI MasterFormat Division 31 25 00. It spans three distinct construction phases: Phase 1 Initial Clearing (perimeter silt fence LF, stabilized construction entrance stone tons, tree protection fencing LF), Phase 2 Mass Earthwork (temporary sediment traps BCY, rock check dams, temporary seeding AC), and Phase 3 Final Stabilization (inlet protection bags EA, slope erosion control blankets SY, and turf reinforcement mats).

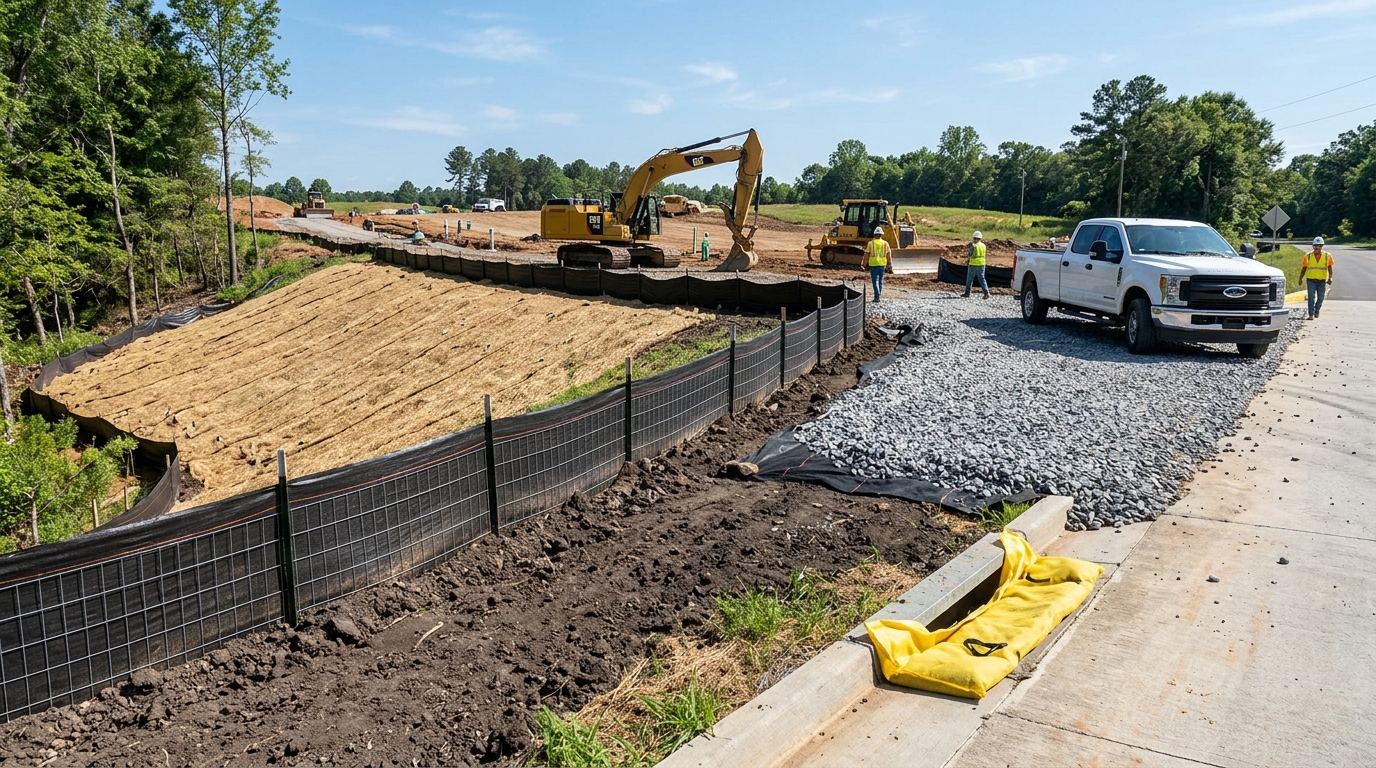

Phased SWPPP erosion control installation showing wire-backed silt fence, stabilized rock tracking pad entrance, and straw erosion blankets
Environmental Sediment Control: Wire-Backed Silt Fence, Stabilized Rock Entrance & Sloped Erosion BlanketsCSI DIVISION 31 25 00 • SWPPP
Mandatory Civil Compliance

Eliminating Bid Day Scope Gaps on Erosion & Sediment Controls

Every permitted construction project across the United States requires an EPA NPDES General Permit or state Department of Environmental Protection (DEP/DEQ) Stormwater Pollution Prevention Plan (SWPPP).

Too often, general contractors treat erosion control as an afterthought allowance, leading to tens of thousands in unbudgeted costs for stone tracking pads, replacement silt fence, and hydroseeding fines. Our dedicated takeoffs extract every Best Management Practice (BMP) specified across Civil ESC plan sheets.

CSI 31 25 13

Perimeter Sediment Barriers

We trace project boundaries and downstream drainage contours to measure linear footage of silt fence. We distinguish standard 36" fabric from heavy-duty wire-backed silt fence and super silt fence with steel posts.

  • Standard vs wire-backed silt fence (LF)
  • Hardwood stakes or steel T-posts
  • Straw wattle / compost filter berms (LF)
CSI 31 25 14

Stabilized Site Entrances

Vehicle tracking pads prevent mud from dragging onto public roadways. We calculate crushed stone ballast tonnage (AASHTO #1 to #3 stone) based on specified dimensions (e.g. 50'x20'x6") and underlying woven geotextile fabric SY.

  • AASHTO #1-#3 aggregate ballast (Tons)
  • Class 1 woven geotextile underlayment (SY)
  • Tire wash rack options where specified
CSI 31 25 16

Slope & Inlet Protection

Inlets must be protected from sediment loading before paving. We itemize drop inlet filter sacks, curb inlet gravel rings, temporary rock check dams, and net square yards of Erosion Control Blankets (ECB) with staples.

  • Inlet sediment filter bags (EA)
  • Riprap check dams & stone filters (Tons)
  • Curlex/jute erosion control blankets (SY)

Mathematical Takeoff Modeling: Ballast Stone, Blankets & Silt Fence

Erosion control pricing requires engineering conversion formulas to properly calculate purchasing units from civil drawing geometry:

1. Tracking Pad Ballast Stone Formula

  • Ballast Stone (Tons) = [Length (ft) × Width (ft) × Depth (ft) ÷ 27] × 1.90 Tons/CY
  • Underlayment Fabric (SY) = [Length (ft) × Width (ft)] ÷ 9
  • Typical tracking pad: 70' × 24' × 0.67' (8") = 41.7 CY = 79.2 Tons AASHTO #1 Stone + 187 SY Woven Fabric.

2. Slope Erosion Blanket & Staple Formula

  • Gross Matting (SY) = Net 3D Slope Area (SY) × 1.15 (15% overlap allowance)
  • Anchoring Staples (EA) = Gross Matting (SY) × 3.5 staples/SY
  • Standard Straw Rolls = Gross SY ÷ 100 SY/Roll (e.g. 8' × 112.5' rolls)
Worked Commercial Subdivision SWPPP Example: An 18-acre site development bid requires:
• 3,600 LF of Standard Silt Fence along property boundaries (360 hardwood stakes at 10' OC).
• 1,400 LF of Wire-Backed Silt Fence along steep 3:1 basin daylight perimeters (233 steel T-posts at 6' OC).
• 2 Stabilized Construction Entrances (70' × 24' × 8"): 2 × 79.2 Tons = 158.4 Tons AASHTO #1 Stone + 374 SY Class 1 Woven Geotextile.
• 28 Drop Inlet Filter Bags & 14 Curb Inlet Gravel Barriers: 42 EA Inlet Protection Assemblies.
• 5,400 SY of Detention Basin 3:1 Slope Stabilization: 5,400 × 1.15 = 6,210 SY Single-Net Straw Matting (63 rolls) + 21,735 Wire Staples.
• 8.5 Acres Temporary Seeding & Straw Mulching during interim earthwork phases.

Standard SWPPP BMP Pay Items & Takeoff Formulas

CSI CodeBMP DescriptionBid UnitMaterial SpecificationStandard Takeoff Multiplier
31 25 13.13Standard Silt FenceLinear Feet (LF)AASHTO M288 woven geotextile, 1.5"x1.5" hardwood stakes1 stake per 6' to 10' LF
31 25 13.23Wire-Backed Silt FenceLinear Feet (LF)14-gauge 6x6 welded wire mesh with steel T-posts1 T-post per 6' LF (1.25 lbs/ft)
31 25 14.13Construction Entrance PadTons / SYAASHTO #1-#3 coarse stone (2"-3") over woven fabric~1.9 tons per CY compacted
31 25 14.23Inlet Protection Silt SacksEach (EA)High-flow woven sediment catch bag under catch basin grate1 EA per proposed structure
31 25 16.13Erosion Control Blanket (ECB)Square Yards (SY)Single/double net agricultural straw or wood curlexNet area + 15% overlap factor
31 25 16.23Temporary Seeding & MulchAcres / SYQuick-germinating annual rye/millet + straw mulch (2 tons/ac)Perimeter cut/fill slopes

Erosion Control & SWPPP Takeoff Specifications & Quality Control Matrix

Takeoff ParameterStandard Service Specification
Measurement UnitsLinear Feet (LF silt fence/wattles), Tons (TN tracking pad ballast rock), Square Yards (SY erosion blanket & turf reinforcement mats), Acres (AC hydroseeding/mulching), Each (EA inlet filter bags/concrete washout basins).
Drawings ReviewedCivil SWPPP & Erosion Control Plans (C500), Phasing Drawings (Initial Clearing Phase vs Mass Grading Phase vs Final Stabilization Phase), and BMP Standard Details.
Specification AlignmentCSI MasterFormat Division 31 25 00 (Erosion and Sedimentation Controls) & EPA NPDES Construction General Permit standards.
Revisions & AddendaPhased delta tracking: changes to limit of disturbance (LOD), sediment basin sizing modifications, and upgraded BMP requirements reflected in line-item updates.
QA/QC Review ProtocolEnvironmental compliance verification checking continuous perimeter sediment barriers along downslope contours, inlet protection at every low-point structure, and proper slope netting overlap allowances (12% to 15%).
Standard ExclusionsState EPA NPDES Notice of Intent (NOI) filing fees, daily/weekly certified SWPPP on-site storm inspections, and permanent flocculant chemical treatment systems (unless requested).

Five Costly SWPPP Bidding Mistakes We Help You Avoid

1. Bidding Single-Phase Erosion Controls on Multi-Year Jobs: Silt fences deteriorate under UV sunlight within 6 to 9 months. On jobs spanning 12 to 24 months, contractors must budget for ongoing maintenance, periodic cleanout dredging, and 50% fabric replacement.
2. Forgetting Woven Geotextile Under Construction Entrances: Placing AASHTO #1 stone directly onto raw soil without a heavy-duty Class 1 separation fabric results in ballast rock sinking into the mud within days, requiring double the stone tonnage.
3. Omitting Wire-Backed Upgrades on Steep Daylight Slopes: Standard hardwood stake silt fence collapses under concentrated stormwater runoff from 3:1 slopes. Upgrading to wire-backed fence with steel T-posts costs twice as much and must be identified upfront.
4. Neglecting Concrete Washout Pits: Every civil site requires dedicated, impermeable concrete truck washout stations. Failing to quantify plastic poly liners, hay bale perimeters, or precast washout containers leads to immediate environmental stop-work orders.
5. Underestimating Slope Blanket Overlap & Anchor Trenching: Civil plans show flat 2D slope areas. Adding 3D slope incline factors, 12" top anchor trenches, and 6" roll overlaps adds 15% to 20% to real-world erosion blanket roll requirements.

Calculate Quantities in the Field

Use our interactive Erosion Control & SWPPP BMP Calculator to calculate linear silt fence runs, construction entrance stone tons, and blanket roll requirements instantly.

SWPPP Guides & Decision Resources

Access our engineering guides for site sediment control and bid verification:

Frequently Asked Questions

How do you calculate stabilized construction entrance stone quantities?

We extract entrance dimensions from civil erosion control details (typically 50-70 ft length x 20-24 ft width x 6-12 inch depth of AASHTO #1, #2, or #3 ballast stone). We calculate volume, multiply by stone compaction density (approx. 1.8 to 2.0 tons/CY), and quantify underlying Class 1 woven geotextile fabric in square yards.

What is the difference between standard and wire-backed silt fence takeoffs?

Standard silt fence uses woven geotextile fabric with pre-attached hardwood stakes spaced at 6 to 10 feet for mild slopes. Wire-backed silt fence includes 14-gauge welded wire reinforcement mesh and heavy-duty steel T-posts for high-velocity runoff zones and steep cut/fill daylight perimeters.

Are temporary seeding, mulching, and erosion blankets included in takeoffs?

Yes. We quantify disturbed soil acreage requiring temporary seeding and straw mulching during interim earthwork phases, as well as permanent hydroseeding. For slopes steeper than 3:1, we measure Erosion Control Blankets (ECB) or Turf Reinforcement Mats (TRM) in net square yards with a 10% to 15% overlap allowance.

How are SWPPP phasing transitions quantified across clearing, mass grading, and paving?

We review phased ESC drawings to segregate Phase 1 initial clearing controls (perimeter silt fence and tracking pads), Phase 2 mass grading controls (temporary sediment traps, rock check dams, and slope diversions), and Phase 3 final stabilization (inlet filter bags, permanent turf blankets, and sodding).

What overlap and waste factor is calculated for erosion control blankets?

Manufacturer installation specifications mandate a minimum 4 to 6-inch longitudinal overlap and 12-inch transverse terminal overlap, plus anchoring staples spaced every 1.5 to 2.0 feet. We add a standard 12% to 15% material allowance to net slope area to ensure sufficient roll ordering.

Need an Itemized Erosion Control & SWPPP Takeoff?

Upload your civil erosion and sediment control (ESC) plan sheets and details. Receive a certified, bid-ready CSI Division 31 25 00 takeoff spreadsheet in 24 to 48 hours.
